Contractor Training • Spring 2026

Single-Component
Products &
Applications

Learn when and how to use single-component polyurethane resins — so you can read soil reports, choose the right product, and confidently sell stabilization projects from solar fields to DOT road work.

~61 minutes Spring 2026 Andy Powell, VP of Sales
SINGLE-COMPONENT PERMEATION Resin flows between soil grains N=7
0
Single-Component Products (AP600, 700, 720)
0
Solar Piles Stabilized (Ft. Green)
0
Piles Moved After Cat 3 Hurricane
0
Installed Price (Solar Field)

Your Instructor

Andy Powell

Andy Powell

VP of Sales, Alchatek

Andy Powell brings years of hands-on field experience with single-component polyurethane applications. He lived in Florida during the company's breakout years in permeation grouting, working alongside contractors on sinkhole remediation, DOT road stabilization, and large-scale soil permeation projects — including NASA's Vehicle Assembly Building at Cape Canaveral.

In this session, Andy walks you through the full single-component product line — AP 600, AP 700, and AP 720 — and shows you how to read soil boring reports, identify permeable soils, and select the right product for every application from elevator pits to solar fields.

Single-Component Permeation Specialist
NASA VAB Project Lead
Florida DOT Projects

What You'll Walk Away With

4 Capabilities You'll Add to Your Business

Single-component polyurethane opens applications that two-component foam can't touch. This session gives you the technical foundation and real project numbers to sell and deliver single-component work.

01

Read Soil Boring Reports Like a Pro

Understand N values, SPT blow counts, sieve analysis, and the number 200 fines percentage so you can evaluate whether a site is a fit for single-component permeation before you ever show up on the job.

02

Select the Right Single-Component Product

Know when to reach for AP 600 (ultra-thin permeation), AP 700 (expanding permeation), or AP 720 (high-expansion seawall/cutoff) based on soil conditions, application type, and project goals.

03

Win DOT and Commercial Contracts

Use engineer outreach, geotech reports, and proven case studies — including NASA and Florida DOT — to position yourself for road stabilization, infrastructure repair, and commercial soil permeation projects.

04

Quote Jobs with Real Numbers

The solar field case study breaks down every line — 3,750 gallons at $42/gal material cost, $337K invoiced, four days of production with two Poly Sharks. You'll leave with the math to price your own single-component projects.

Inside the Session

Training Highlights

DOT geotech boring log plan view
Reading Geotech Reports
Single-component product lineup AP600 AP700 AP720
Single-Component Product Lineup

Fort Green solar field site
Solar Field — 5,000 Piles
Breakers Hotel courtyard excavation wall
Excavation Assist Wall

Session Walkthrough

What You'll Learn, Step by Step

Andy covers every aspect of single-component polyurethane — from soil science to field execution to job pricing. Here's the complete roadmap.

0:00 – 5:00

When Single-Component Is the Right Fit

Andy opens with the fundamental question: is the soil permeable? Single-component resins permeate between soil grains — they need sandy, gravelly soil to work. Clay and silt are too fine. Understanding this distinction is the first step to knowing when single-component is the right call versus two-component foam.

N-values chart for cohesive vs non-cohesive soils Andy opening the session Single-component product lineup
5:00 – 16:00

Reading Soil Boring Reports & N Values

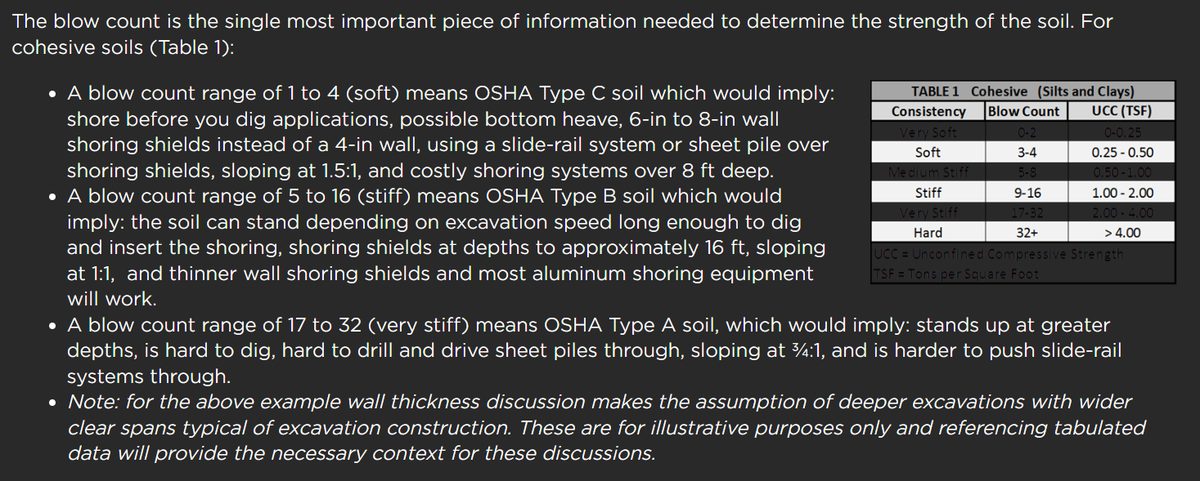

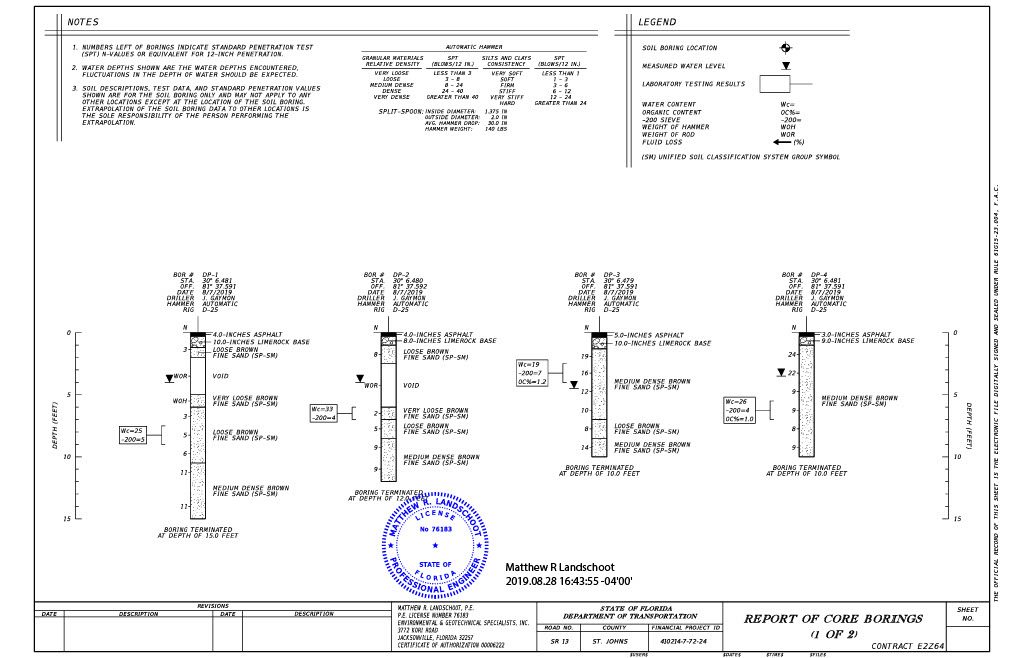

The deep dive into geotech reports: Andy walks through a real Florida DOT boring log — what SPT blow counts mean, how to read N values for sandy vs. cohesive soils, what “weight of rod” and “weight of hammer” tell you about void conditions, and why the number 200 sieve percentage (fines under 12%) determines whether you can permeate the soil.

DOT project plan view with boring locations Andy explaining boring logs Soil boring log detail
16:00 – 25:00

The Three Single-Component Products & Equipment

Andy breaks down the product lineup: AP 600 (37–40 centipoise, ultra-thin, for excavation walls and elevator pits), AP 700 (100 centipoise, 30x expansion, for grid-pattern compaction and water cutoff), and AP 720 (40–50x expansion, for seawalls and bulkheads). All are heavier than water, hydrophobic, and work in the water table without dewatering. The Poly Shark pump system — gas over hydraulic, two 400-foot hose reels with flow meters — lets you park on the street and run hoses to the work area.

AP600 AP700 AP720 product comparison Andy presenting single-component products Equipment overview
25:00 – 33:00

Alternatives to Excavation — Real Case Studies

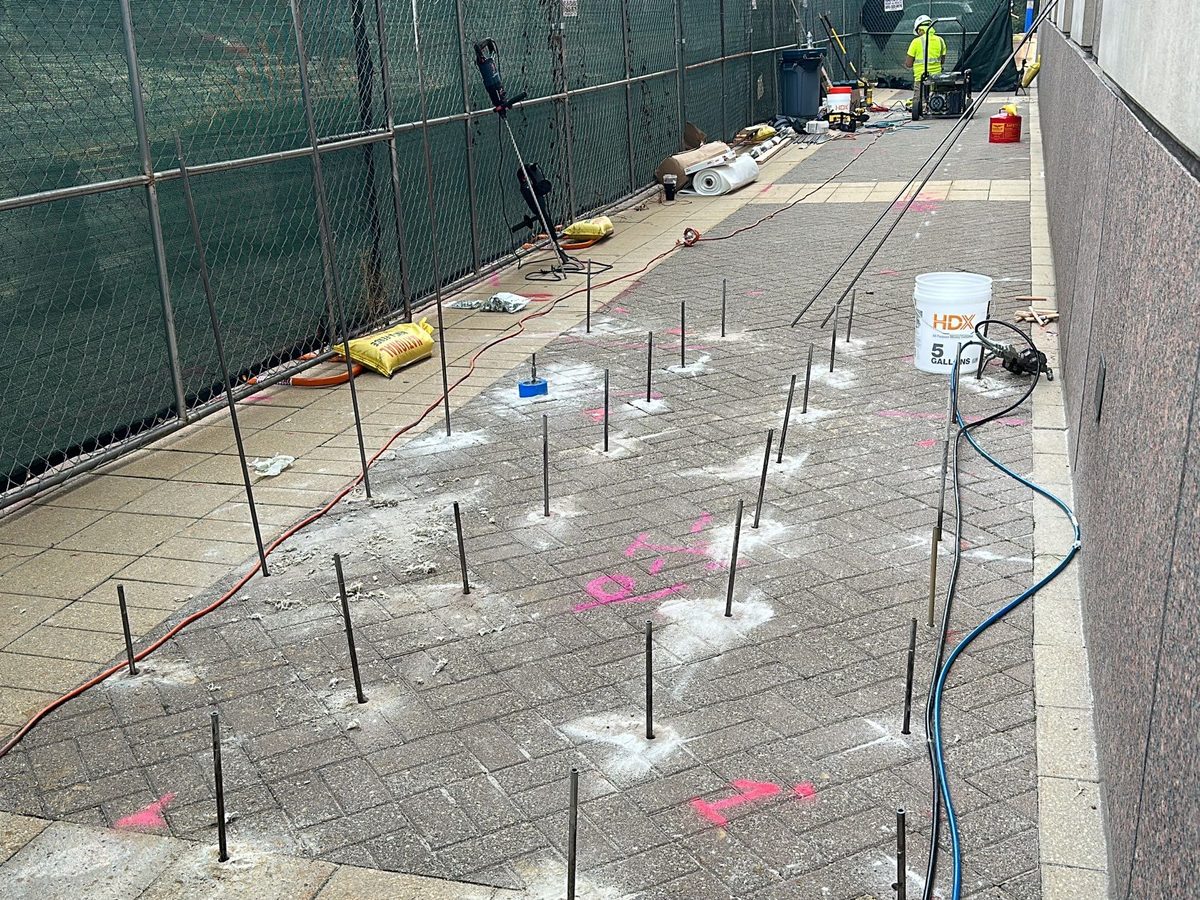

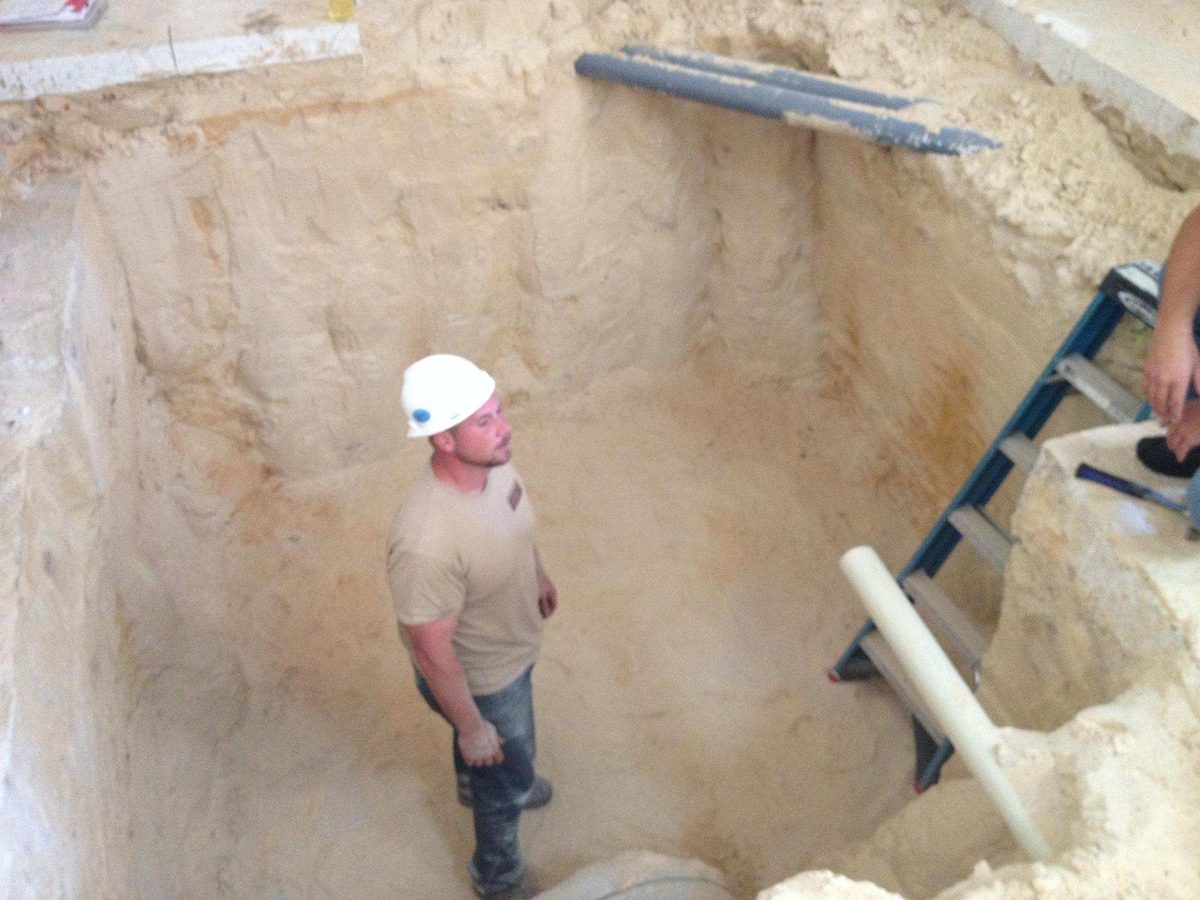

The Cohen Building in New Jersey: a federal courthouse with deep infrastructure, heavy foot traffic, and settling walkways. Nine totes of AP 700 at 5% catalyst, pumping from depth and pulling rods up — a gallon per vertical foot. Then the elevator pit at Archer Sand in Gainesville: a 55-and-up community where you can't drive sheet pile inside a building. AP 600 permeation built the excavation walls so they could dig the pit safely.

Cohen Building federal courthouse project Andy explaining the technique Elevator pit excavation assist
33:00 – 38:00

Single-Component Application Categories

Andy runs through the full market: DOT road stabilization in organic soils, water cutoff walls for soil dams and spillways, excavation assist for zero-lot-line buildings, foundation support next to existing structures, historic building stabilization with brick foundations, and seawall/bulkhead erosion repair. Every application where you have permeable soil is a single-component opportunity — and the work is everywhere once you know where to look.

Andy discussing application categories
Live Andy covers the full range of single-component market segments
38:00 – 43:00

NYC Building — Single + Two-Component Combined

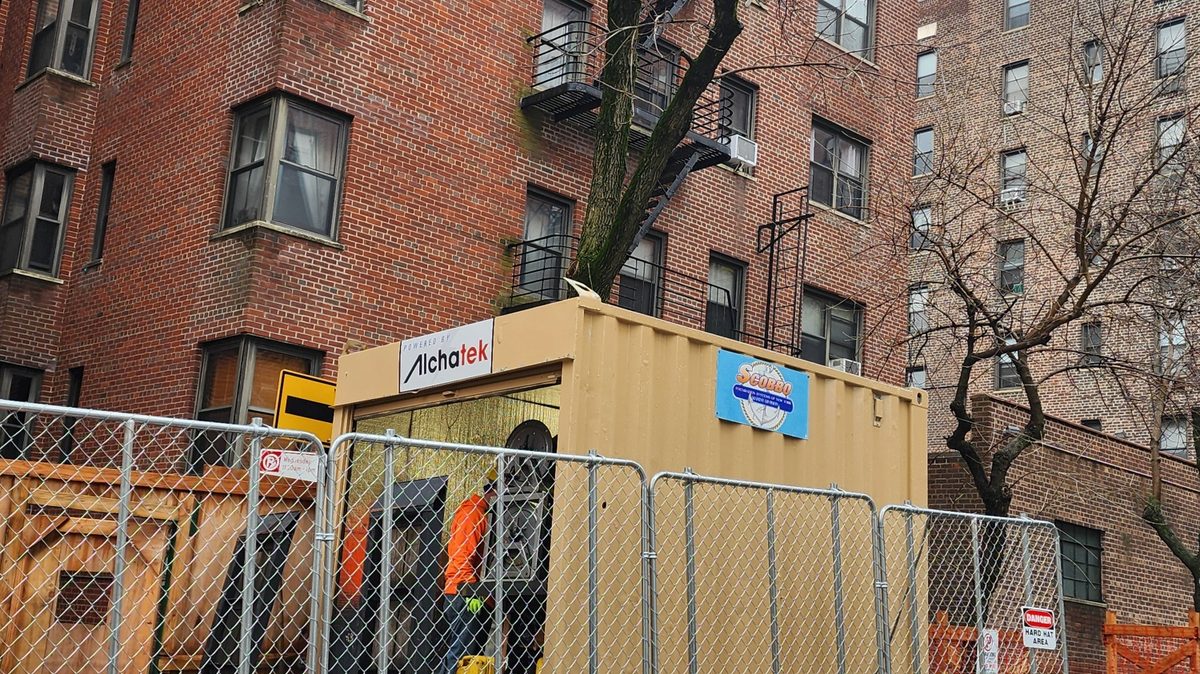

Frank shares the NYC project: a 64-unit occupied building that was sinking, with the building department demanding evacuation. The team used single-component to fill voids at depth, then two-component on top for lifting — 220 injection points, 23 feet deep, two and a half years of work. Single-component curtain walls on both sides stopped an underground stream. It proved that single-component and two-component work together in the most demanding conditions.

NYC building stabilization Andy and Frank discussing the project Group discussion about the NYC project
43:00 – 52:00

Fort Green Solar Field — The Numbers

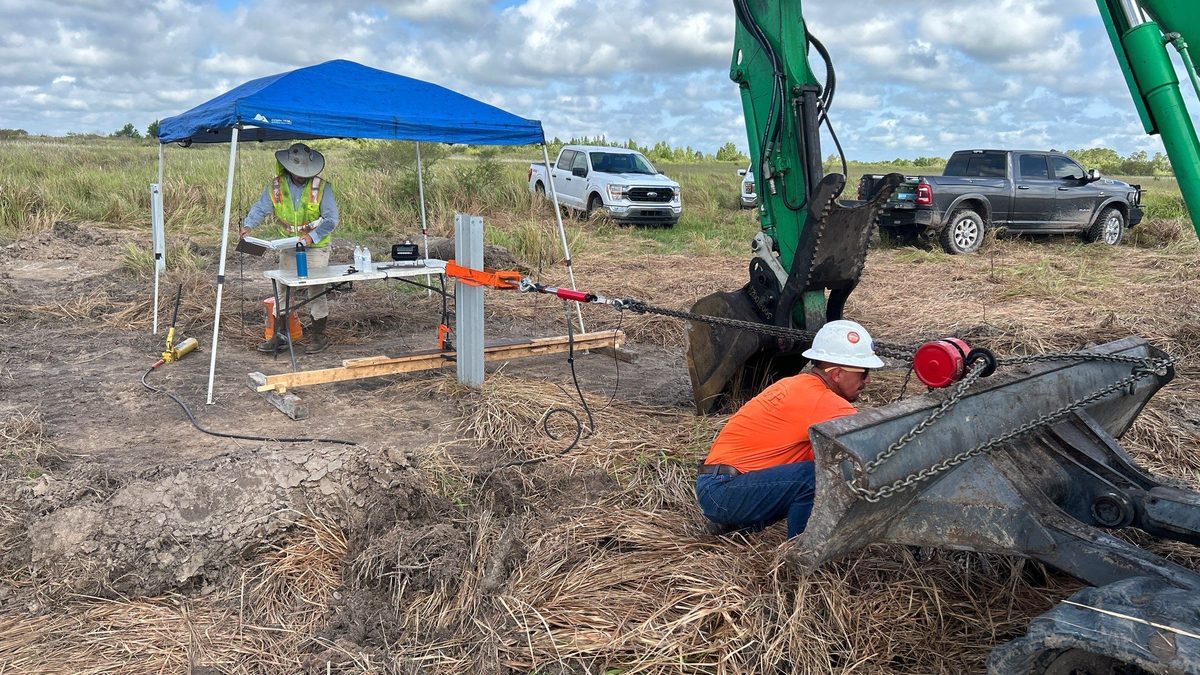

The definitive single-component case study with full financials: 40,000 total H-piles, 5,000 failing pull tests. Three-quarters of a gallon of AP 600 per pile, four feet down. Material cost: $42/gallon, $157K total. Production: 1,200 piles per day with two Poly Sharks and four operators. Invoiced at $90/gallon — $337K total, done in four days. Then Hurricane Ian hit as a Category 3: out of 5,000 treated piles, only 9 moved.

Fort Green solar field after hurricane Andy breaking down the numbers Terracon compression and lateral testing
52:00 – 56:00

Excavation Walls & Grid Patterns

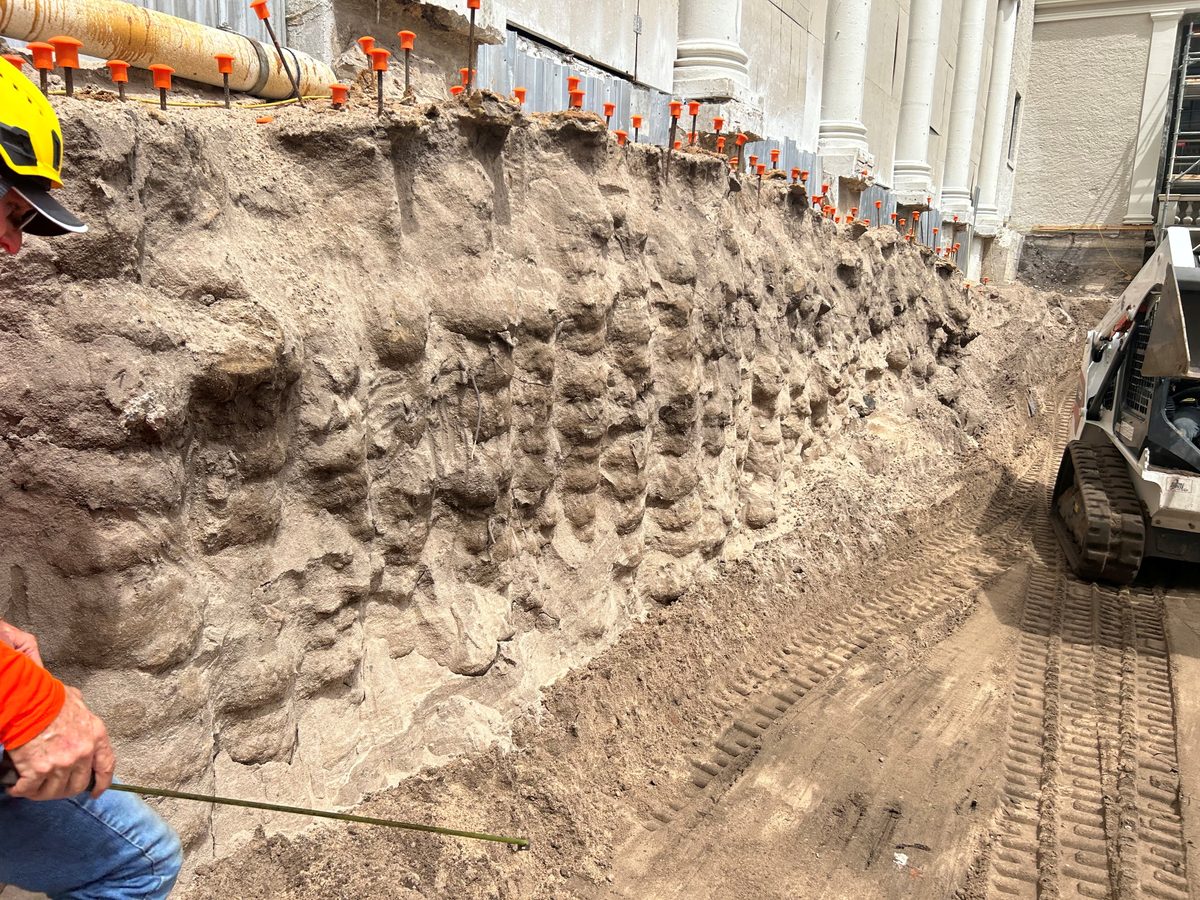

The Breakers Hotel courtyard project: a seven-foot permeation wall done at 12 inches on center with multiple injection rows, engineered to resist overturning forces. Andy covers grid pattern spacing — 3–4 feet for soil stabilization, 12–15 inches for excavation walls — and the critical technique of letting the first gallon set before stacking to avoid bell-shaped columns instead of clean pillars.

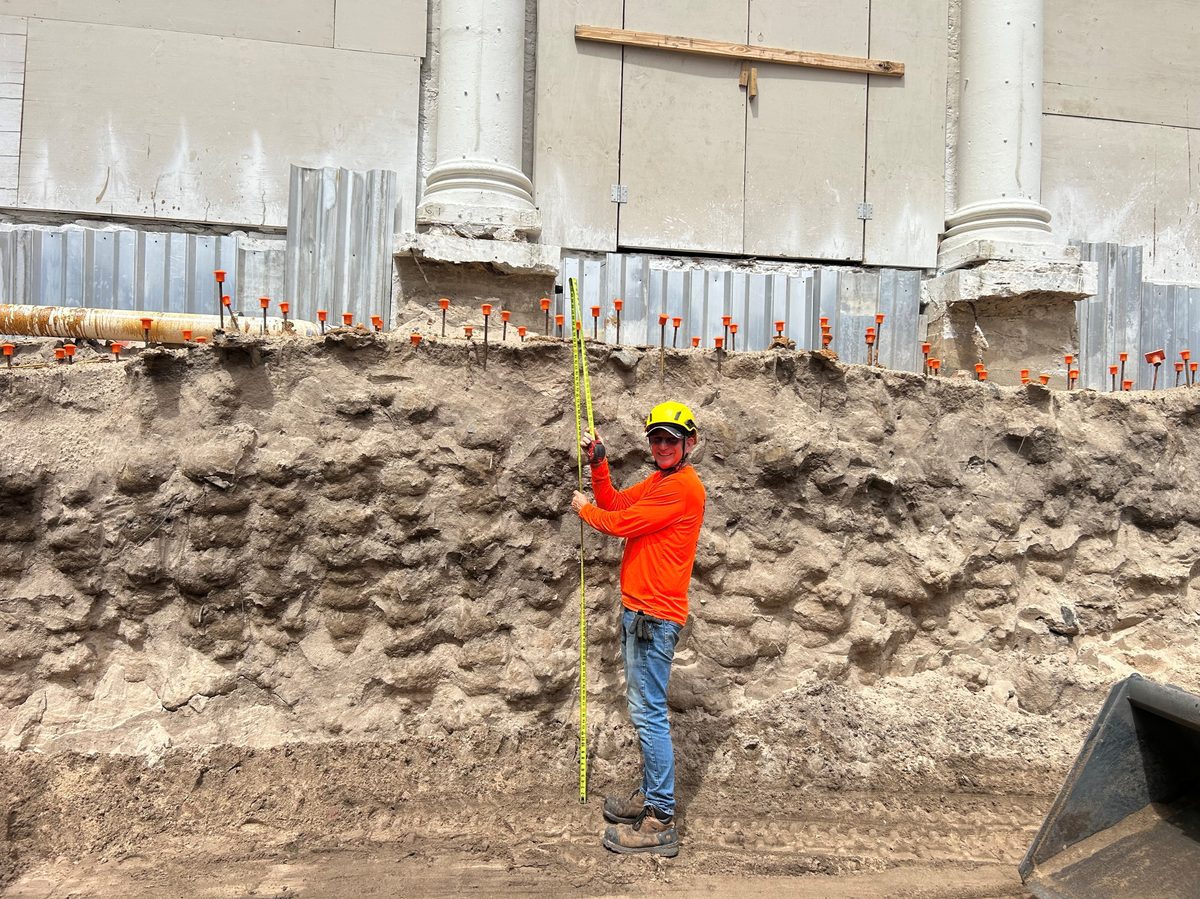

Breakers Hotel excavation wall Andy explaining grid patterns Excavated permeation wall exposed
56:00 – 61:00

The Value Proposition & Wrap-Up

Andy closes with the message that hasn't changed in years: you're already making the same sales calls — now you can offer deep soil stabilization on every one. Single-component is fast to install, proven in service for 40+ years, less invasive than excavation, requires no permits for most work, and combines with helicals, manta rays, and traditional underpinning. The NASA VAB, Florida DOT, and solar field projects prove it works at every scale.

Deep Lock value proposition slide Andy delivering the closing message Solar pile testing success

Session Gallery

More from the Training

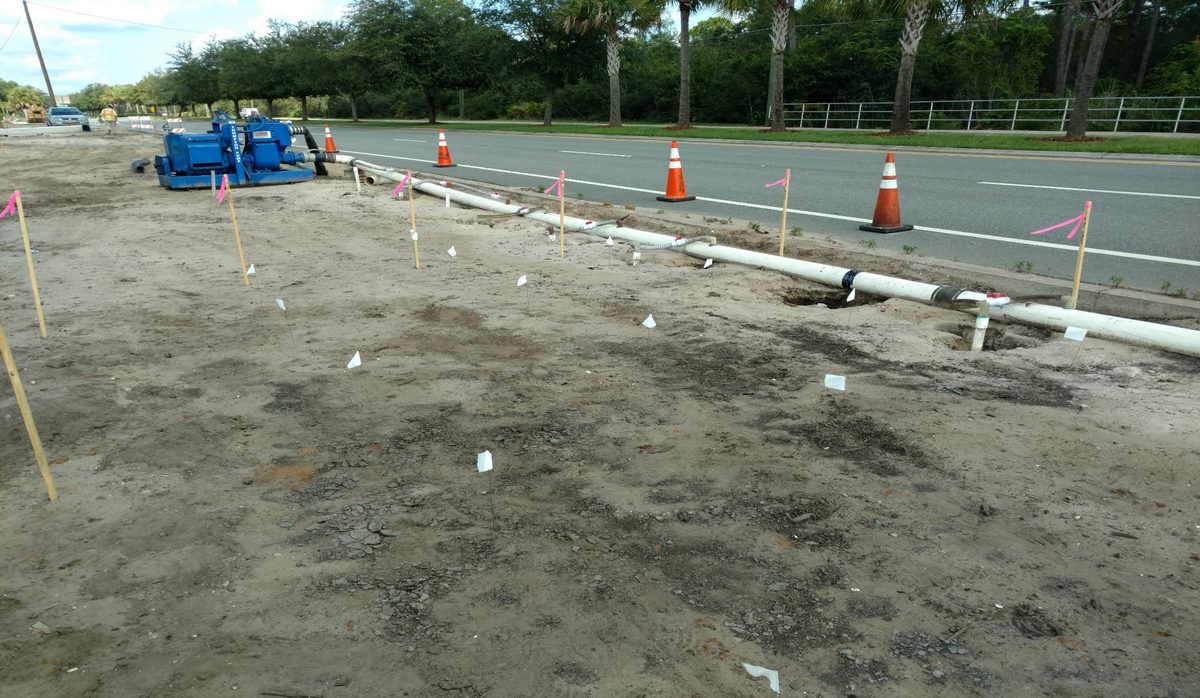

Florida DOT road stabilization
DOT Road Stabilization

CPT rig cone penetrometer testing
CPT Cone Penetrometer
Elevator pit excavation assist
Elevator Pit — AP 600
Single-component grid pattern spacing diagram
